DPW Project
AHBC Update Highlights Strained Process
Work session surfaces trust issues and questions about next steps
During a Select Board meeting, officials reviewed outcomes from an Ad Hoc Building Committee work session focused on the DPW project. While some strengths were noted, all members identified back-channel communications and internal division as serious impediments. With the committee split into opposing camps and pricing soon to be released, questions were raised about whether the existing structure can credibly guide the project forward.
video clip edited for clarity and length
Questions Emerge About a “Shadow” Committee
Public records prompt scrutiny of Truro’s DPW planning process
At a recent Select Board meeting, a Truro resident presented public records he says reveal a pattern of behind-the-scenes coordination involving committee members, staff, and a consultant tied to the DPW project. He argues that alternatives were never seriously considered and warns the process could expose taxpayers to unnecessary costs.
While urging the town to continue planning work, he called for greater transparency and oversight before further commitments are made.
AHBC Update Signals Ongoing DPW Planning Challenges
Select Board hears brief status report on AHBC
In a short update to the Select Board, the Ad Hoc Building Committee liaison reported on the current status of the DPW facility project. The discussion outlined progress, remaining challenges, and noted that the committee is hoping to receive the first schematic from Weston & Sampson by May 5.
AHBC Work Session Recast Ahead of Key Decisions
Facilitated session aims to address challenges and next steps
At a recent meeting, the Select Board agreed to revise the structure of an upcoming Ad Hoc Building Committee work session. Citing timing concerns and internal difficulties, members supported a smaller, facilitated discussion limited to the committee and its liaison. The session is intended to address internal challenges, surface unresolved issues, improve alignment, and and help members decide whether to seek reappointment as current terms near expiration.
Citizens express need for a $20 million cost cap
“If it doesn’t begin with a 1 it will end up a zero”
OPM Update
Provides his estimate of cost in the $26M to $30M range
Suggests how to get to about $20M: “If you want to lop off $8, 9, 10 million you’ve got to cut out about a third of something… It’s an option… It depends on your priorities…”
Update from OPM
OPM comments Town Hall Hill site looking like a fit.
OPM:
"Based on what I've seen so far, and if it gets smaller obviously it's going to fit even better."
"I'm asking for the architect to come up with the next level of drawings [as the] site here would require careful sequencing and phasing ... again in all due respect to the [DPW Study] Group, they did a very nice job looking at a concept -- the concept needs to be developed slightly further."
"...my cost of $29.2 million that I started off with is the cost for a brand new building on a brand new site somewhere in town."
Update on Environmental Site Assessment
DPW Environmental Site Activities update from HRP
Owners Project Manager hiring
Focus Turns to Defining DPW Facility Requirements
A clear statement of requirements is one of the next steps to be taken
The Ad Hoc Building Committee held a detailed discussion about how to define clear requirements for a future DPW facility. Participants raised questions about changing square footage estimates, consultant recommendations, and past cost-reduction efforts. The conversation highlighted broad agreement that existing concepts are purely conceptual and that clearer, agreed-upon requirements will be essential before advancing design or site decisions.
Ad Hoc Building Committee Update of Phase 2 Environmental Findings
Finalizing testing including monitoring wells
Ad Hoc Building Committee Update of Phase 2 Environmental Findings
Continues testing including monitoring wells
Select Board Discussion of Phase 2 Environmental Progress
So far a green light for site development.
Board of Health Discussion of Phase 2 Environmental Progress
Further test pits not finding anything requiring action.
Ad Hoc Building Committee Discussion of Phase 2 Environmental Findings
Initial test pit findings, with one having buried oil containers.
Voters Overwhelmingly Approve Funding For Next Steps
Votes: 393 Yes, 94 No, to create a schematic design for the DPW at Town Hall Hill
Select Board Discussion of DPW and Town Meeting Votes
Next steps to be taken at Town Hall Hill.
Select Board Goals
DPW Goal discussion
Select Board Review of Ballot Question 2
Recommendation to approve the engineering budget on June 27 ballot.
Select Board Goal #4 Review
Next step to approve the engineering budget on June 27 ballot.
Ad Hoc Committee: Parking and Site Fill Balancing
Plans evolve for the site, including parking
Ad Hoc Committee: THH Environmental Study
Plans to do a thorough environmental analysis of the Town Hall Hill site before construction.
Town Meeting Votes against DPW at Route 6 and for DPW at Town Hall Hill
Route 6 Site Rejected, and Funding Passed to Design on Town Hall Hill
Six Key Votes on May 4-5 affirmed the Town Hall Hill site:
STM Article 2 - Change of Use of 340 Rt 6
A majority of more than 2/3 of the voters rejected the change of use of the parcel on Rt 6
STM Article 3 - Borrowing Authorization of $28.3 million for DPW construction
Failed by more than a 2/3 majority of the voters

STM Article 4 - Borrowing Authorization of $2.8 million for DPW engineering
No site was specified. 66.7% in favor required to pass, and only 47.3% voted in favor.
STM Article 14 - DPW Campus Design
Passed by a majority of voters.
ATM Article 13 - Borrowing Authorization of $2.8 million for DPW engineering at Town Hall Hill
Voters passed an amendment allocating up to $2.8 million for engineering and design of a new DPW on Town Hall Hill
Ad Hoc Committee: Design Fees Estimates
Weston & Sampson explains that design fee is based on level of effort and NOT a straight 10% of the total project cost.
Ad Hoc Committee: Public Comment
Brian Boyle discussing issues that can put the project at Rt 6 at risk.
Ad Hoc Committee: Reducing the DPW Square Feet
Discussion of reducing the square feet by about a third.
Route 6 Site Traffic Issues
Widening the curb cut onto Route 6 requires MA Department of Transportation approval, which apparently takes years.
- Jarrod Cabral, DPW Director
Route 6 Site More Costly
Not the cheapest in terms of site work.

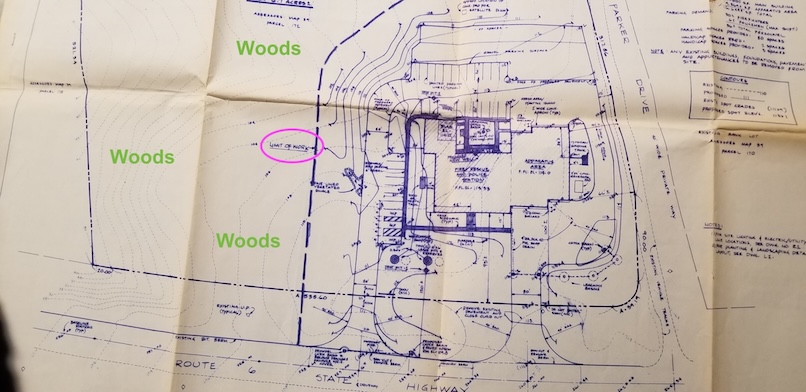

Route 6 Site Layout - Don't See How It Works
-- Chris Lucy (works at the DPW)
Route 6 Site Traffic Issues
Ad Hoc Committee: DPW Vehicle Fleet Size
Starting in 2017, reduced to 17 vehicles now
DPW Community Forum
Some Highlights from the DPW Forum held March 27 at the Community Center
Ad Hoc DPW Building Committee restricted to Route 6 site only
Citizens' Petition
New DPW Facility on Town Hall Hill - Engineering and Site Planning for Two Existing Conceptual Plans

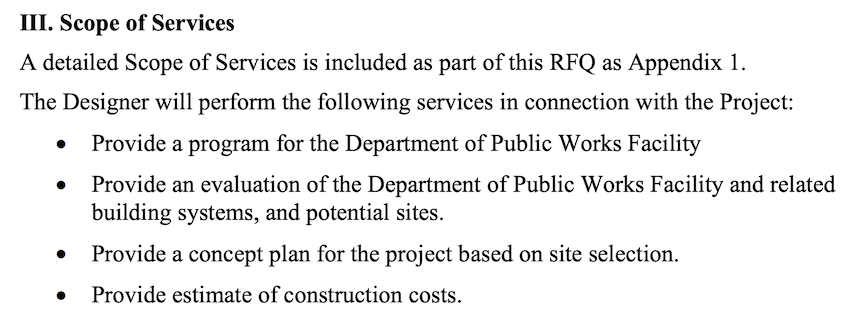

Select Board Appoints Ad Hoc DPW Building Committee
Adaptive Building Reuse In Truro

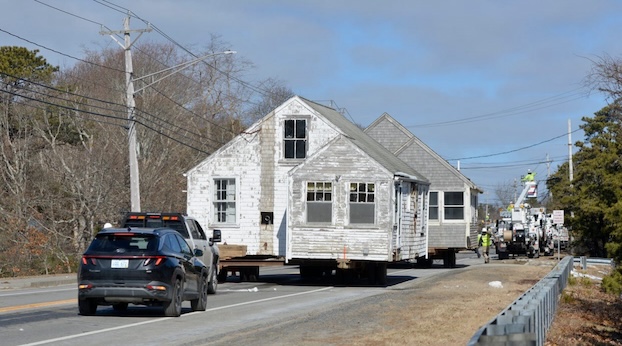

The Town recently reused two houses and moved them from their locations to S. Highland Rd, to give them a second life.
Reusing the 5,000 SF salt barn for vehicle storage saves approximately $3 millon:
assuming $800/SF cost new less $200/SF refurbishing cost equals $600/SF saved.
MISINFORMATION ALERT!
Bob Weinstein claims the DPW Study Group's architect is not registered in MA.
None of the members of the Study Group are licensed in MA.

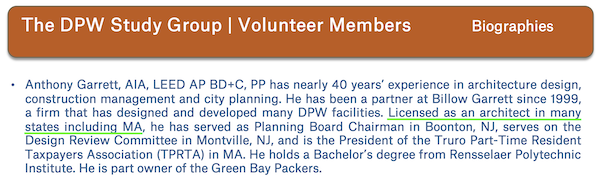

Anthony Garrett, with nearly 40 years' architectural experience, is a licensed architect in several states, including MA.

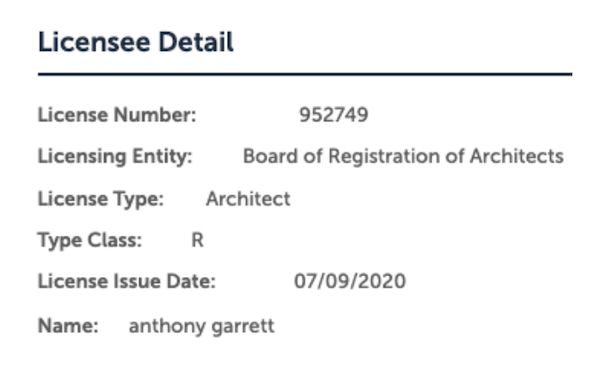

Anthony Garrett's MA Architect License
Town Hall Hill Campus Concept Plan Receives Praise from Leading Architect
Truro taxpayer Elton Elperin, praised the DPW Campus Plan after reviewing the W&S plan and the DPW Study Group Campus Plan documents.
MISINFORMATION ALERT!
Chris Lucy says the DPW will not fit on Town Hall Hill.
That the Town Hall Campus Plan doesn't fit, and states that it measures 400' or 450' on the Meetinghouse Rd side.
Weston & Sampson has tested the Town Hall Hill site and confirmed that a 29,600 SF DPW would fit if the well were relocated.
DPW Study Group's AutoCAD concept plan cites the dimension of the border along Meetinghouse Rd. The plan shows 350.3 feet, which is within a few feet of the measurement cited by Lucy as correct.
Citizens' Petition at Pre-Special Town Meeting
New DPW Facility on Town Hall Hill - Presentation to Pre-Town Meeting
Town Hall Hill Campus Concept Plan Receives Positive Peer-Review
Prominent construction management firm Phelps Construction Group finds the conceptual budgets prepared by the Study Group to be accurate.
MISINFORMATION ALERT!

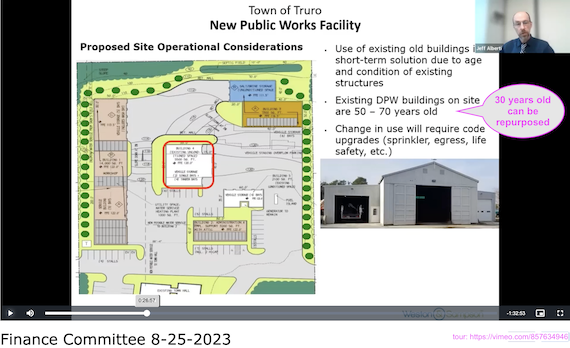

Weston & Sampson states existing Town Hall Hill DPW buildings are 50 to 70 years old.
Presentation by Jeff Alberti of W&S says all existing buildings are 50 to 70 years old, including the two being repurposed.
Actual building age per DPW Director is much less. The larger of the two being repurposed for vehicle storage, at about 5,000 sq ft, was added to in the late 80s to the early 2000s.
W&S Feasibility Study - Update
DPW project COST increased by $4,763,120 to $34,364,120
W&S Feasibility Study - Review by CHA
340 Rt 6 site: $28.2M, Town Hall Rd site: $25.1M
Rt 6 site is $3.1 million more than Town Hall Rd site
Rare Species at 340 Rt 6
As reported by Truro Police Department.
DPW Study Group Publishes Town Hall Hill Campus Concept Plan
Volunteer group comes together in an effort to save taxpayer costs while meeting all stated requirements.
Select Board Votes to Select 340 Route 6 Site
...motion made without hearing from the public.
Bob Weinstein questions voters' role in the site choice
Sue Areson clarifies the provisional nature of the site choice
Neighborhood's Attorney David Reid on 340 Route 6 Site
Abutter Ed Kinsella Discusses Neighborhood Concerns
Select Board Chair Requires Public Comments Be Held Until the DPW Agenda Item
...and states the public will have the opportunity to speak at that time.
Public Works Facility Update, Discussion, and Possible Vote on Site Location

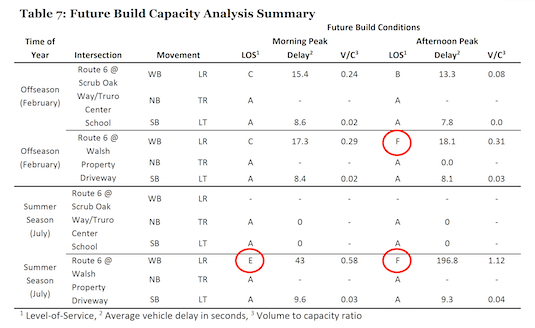

Cape Cod Commission Traffic Study for Rt 6
MA-Licensed Architect Anthony Garrett Joins the Group
The 'DPW Study Group' continued to develop a lower cost Town Hall Hill Campus Plan concept.
W&S Suggested Exploring Town Hall Hill Well Relocation
From the DPW to Snow's Field or to abutting parcels
W&S Feasibility Study - Update
DPW project COST increased by $7,000,000 to $29,600,000
Review of W&S and Current Town Hall Hill Site
Experienced Developer Reviews Site and Plans
Job Swap
Reed and Weinstein swap jobs; Reed is now SB Chair.
Route 6 Traffic Considerations
DPW Director to Select Board: accident history on Rt 6
W&S Feasibility Report - Update
COST increased by $4,618,000 to $22,600,000
SB votes to dissolve Water Resources Oversight Committee
Standing Building Committee remains empty.
